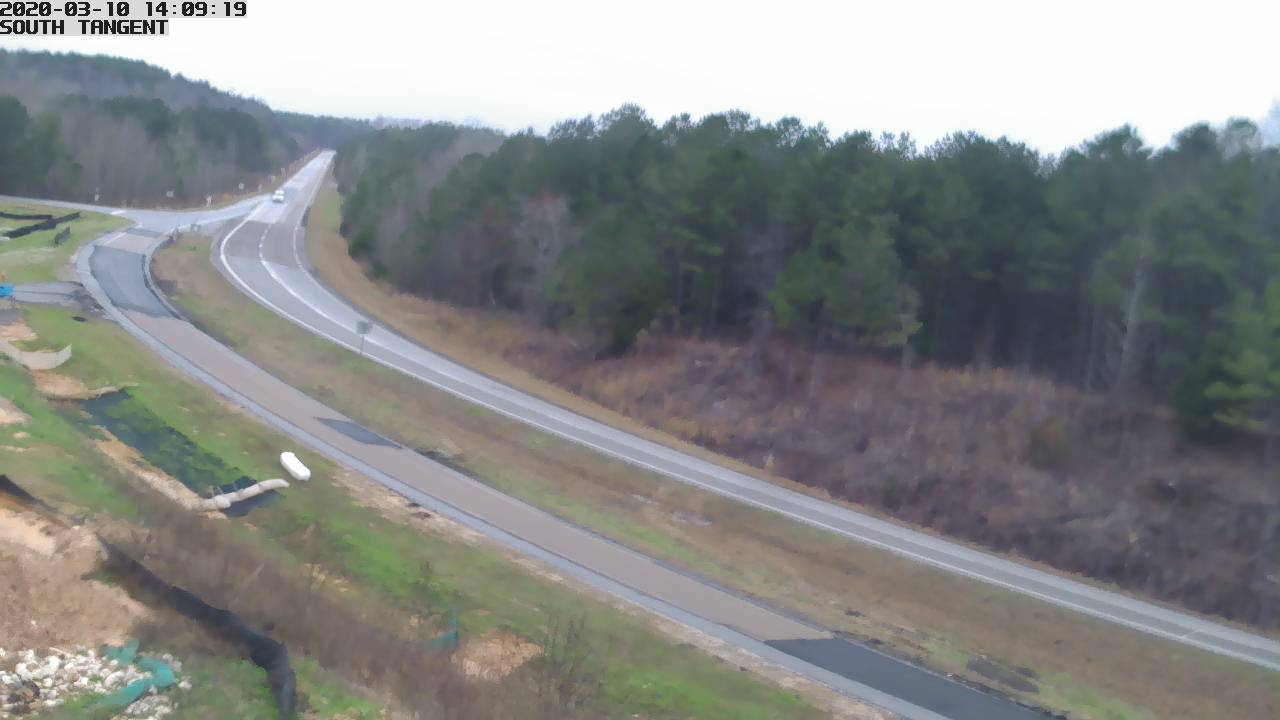

current color radar or preview
local forecast.
10,000,927 ESALs as of 2300 hours on December 4, 2008 (100% of the 10,000,000
ESAL goal !).
CONTACT
this project via...
NCAT_Pavement_Test_Track
1600_Lee_Road_151 Opelika,_AL_36804_USA 334.844.7304

GOD BLESS AMERICA !
| |

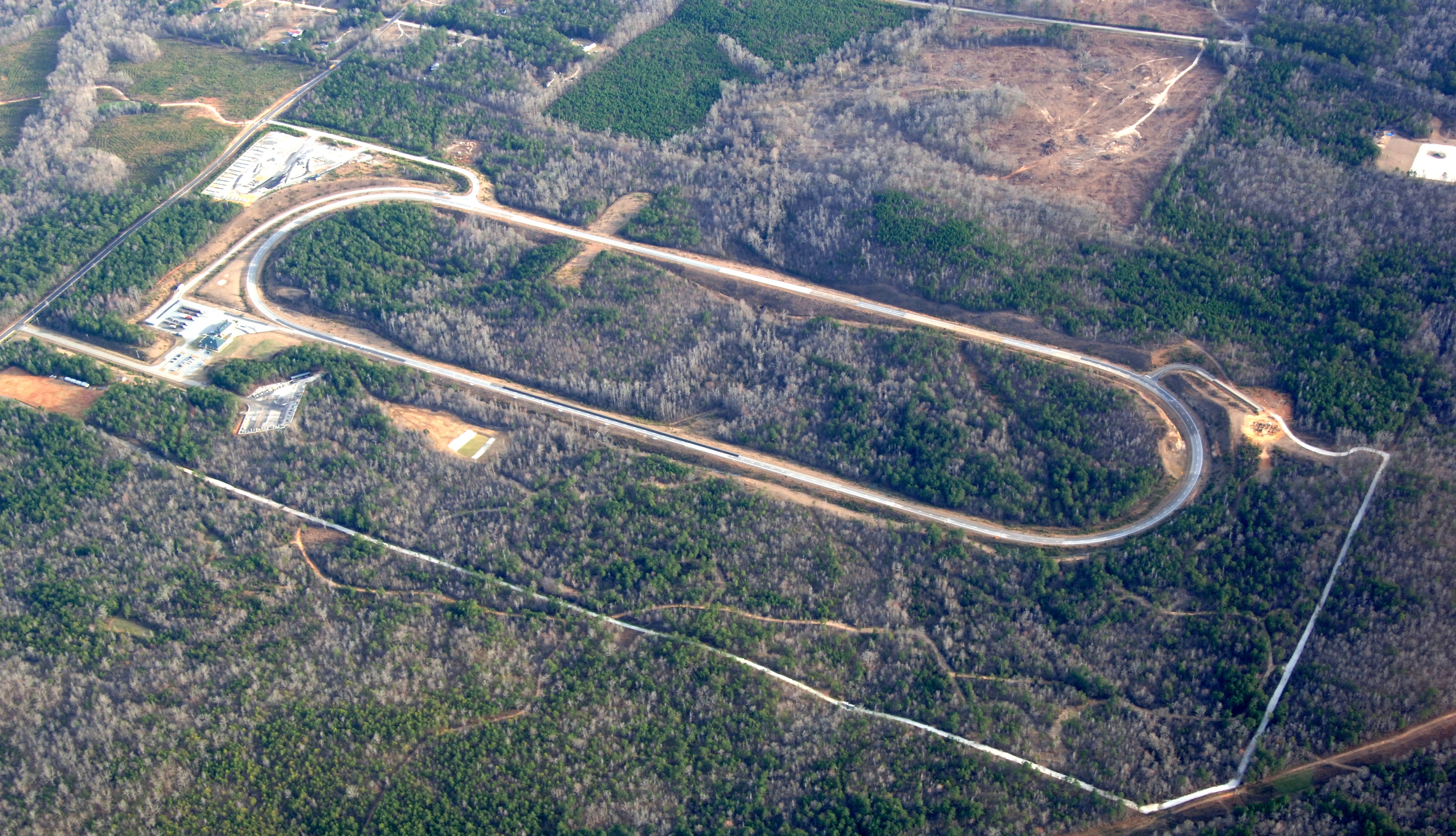

Aerial of 309 Acre Site (Click here for Photo Album, or
Click Aerial to Select Web Camera)
 | WELCOME to the home page for the NCAT Pavement Test Track. The
primary objective of this site is to effectively communicate our experiences
to the world as we administer research designed to reduce the life cycle cost of flexible
pavements. Experimental mixes on our 1.7 mile oval (located about 30 minutes from the
campus of Auburn University) are installed in 200 ft
test sections that facilitate meaningful field performance comparisons, and laboratory
testing is conducted on samples made during construction to facilitate practical lab to
field performance correlations. Anyone interested in test section sponsorship
(which is open to both public and private participation) is encouraged to contact either
Randy West (westran@auburn.edu) or Buzz Powell (buzz@auburn.edu) for additional information. The
fourth research cycle, which is currently under construction, is also advertised on pooledfund.org.
We appreciate your interest and value your feedback.
|
 | CONSTRUCTION - Reconstruction activities for the
2009 research cycle are expected to be complete in July of 2009 in order to facilitate the
initiation of fleet operations while summer pavement temperatures are extremely hot.
MySpace messaging will be used to post pictures
and update sponsors on the status of Track
reconstruction. The schedule can
change daily as a function of the weather and progess to date, so interested parties are
encouraged to check back on a regular basis.
|
 | INSTRUMENTATION - Multidepth temperature
thermister probes are installed in all 46 sections on the Track. Paired with data
from an onsite automated weather station, these data are used to precisely characterize
the performance environment for each experimental section. Additionally, the
sections that make up the structural experiment have high speed instrumentation arrays
consisting of strain gauges and pressure plates installed at select depths.
Measurement data generated by these devices are used to quantify the pavements' response
to passing loads, which is useful in validating pavement analysis and design
methodologies that are mechanistically based. A wireless mesh network has been
deployed along the entire length of the Track to facilitate high speed data transfer in a
safe and efficient manner.
|
 | TRUCKING - This type of research is known as accelerated
performance testing (APT) because a design lifetime of truck damage (typically 10 to 15
years) is induced in 2 years. Trucking operations are planned to begin before the
end of July for the 2009 research cycle in order to challenge new pavements with high
summer temperatures. While the fleet is operational, an AM driver shift runs from
5:00 AM until approximately 2:00 PM, and a PM driver shift runs from 2:00 PM until
approximately 11:00 PM. Each rig in the 5 truck fleet targets running 680 miles per
day (340 miles per driver) in order to damage experimental pavements. Since all
sections are subjected to identical and precisely monitored levels of traffic, it is
possible to complete meaningful intrasponsor and intersponsor field performance
comparisons. Running so many miles in a controlled manner creates a great
opportunity to conduct heavy truck research, and we are working closely with the trucking
industry to meet their research needs in a manner that complements the work we do for the
paving industry. Select reports from the Program for Advanced Vehicle Evaluation
(PAVE) are available for download.
|
 | FIELD PERFORMANCE - Every Monday, trucking is
suspended so that vehicle maintenance can be performed and pavement performance can be
quantified. An inertial profiler equipped with a full lane width dual scanning laser
"rutbar" is run weekly around the entire Track in order to determine individual
wheelpath roughness, right wheelpath macrotexture and individual wheelpath rutting for
every experimental section. Additionally, 3 random locations were selected within
each section in a stratified manner to serve as the fixed test location for nondestructive
wheelpath densities. Transverse profiles are measured along these same locations so
that rutting may be verified using a contact method. Falling weight deflectomer
testing is typically run weekly, which is also the case with high speed structural
response data collection and surface crack mapping. Every month, wet ribbed surface
friction testing is run with a full scale friction trailer. Sound and permeability
testing are run quarterly in order to characterize how the pavement surfaces are changing
over time. Cores are cut each quarter from the wheelpath of every section so that
densification of each layer can be considered.
|
 | LAB PERFORMANCE - To facilitate lab to field
performance correlations, a very large amount of actual plant run material is sampled at
the time test sections are constructed. This material is placed into storage and
used to fabricate specimens for many different types of laboratory performance
characterization. Mix that was placed in the bottom of pavement test sections is
subjected to beam fatigue and push-pull testing in order to characterize resistance to
fatigue. Mix that was placed in surface layers is subjected to dynamic modulus, flow
number, APA and Hamburg testing in order to quantify resistance to permanent deformation.
Surface mixes are also subjected to overlay testing, semi-circular bending, IDT
creep/strength testing and energy ratio testing in order to characterize each mix's
cracking susceptibility. Numerous other tests are run on mix constituents in order
to asses their contribution to pavement performance.
|
 | COMMUNICATION - Representatives from each research
sponsor are onsite while test sections are being built in order to provide oversight and
ensure that as-built properties best meet their research needs. Meetings of the
entire sponsor group are hosted at the Track every 6 months thereafter in order to share
preliminary results and plan for the future. At each meeting, the first day consists
of classroom presentations and discussions, while the second day is spent on the Track
inspecting test sections. The last 6-month sponsor meeting was held on February 9,
2009 in conjunction with the end-of-cycle Track
Conference. Many reports on Track research have been published and are
available for download.
|
|
